China sourcing delays usually do not come from one holiday. They come from stacked dependencies.
2026-08-21 update: China’s official 2026 Spring Festival holiday was Feb 15–23 and National Day is Oct 1–7. The official 2027 holiday schedule is not yet available here, so do not publish invented 2027 dates; use planning windows until the State Council publishes them.
A paddle launch may require material booking, sample development, artwork, golden-sample approval, certification, mass production, inspection, packaging and freight. If any one of those steps lands inside a factory shutdown or peak-capacity period, the entire launch can move.
The safest approach is to plan backward from the required warehouse or retail date rather than ask the factory, “How many days is production?”
Start With Official Holiday Windows
Know the Official 2026 Holiday Windows
China’s official 2026 holiday arrangement set the Spring Festival holiday from February 15 through February 23, with adjusted workdays on February 14 and February 28. National Day is scheduled from October 1 through October 7, with adjusted workdays around the holiday.
Those are public-holiday dates—not a guarantee that every factory, raw-material supplier or logistics provider operates normally immediately before and after them.
Factories often experience staff travel, upstream shutdowns and restart ramp-up beyond the formal calendar.

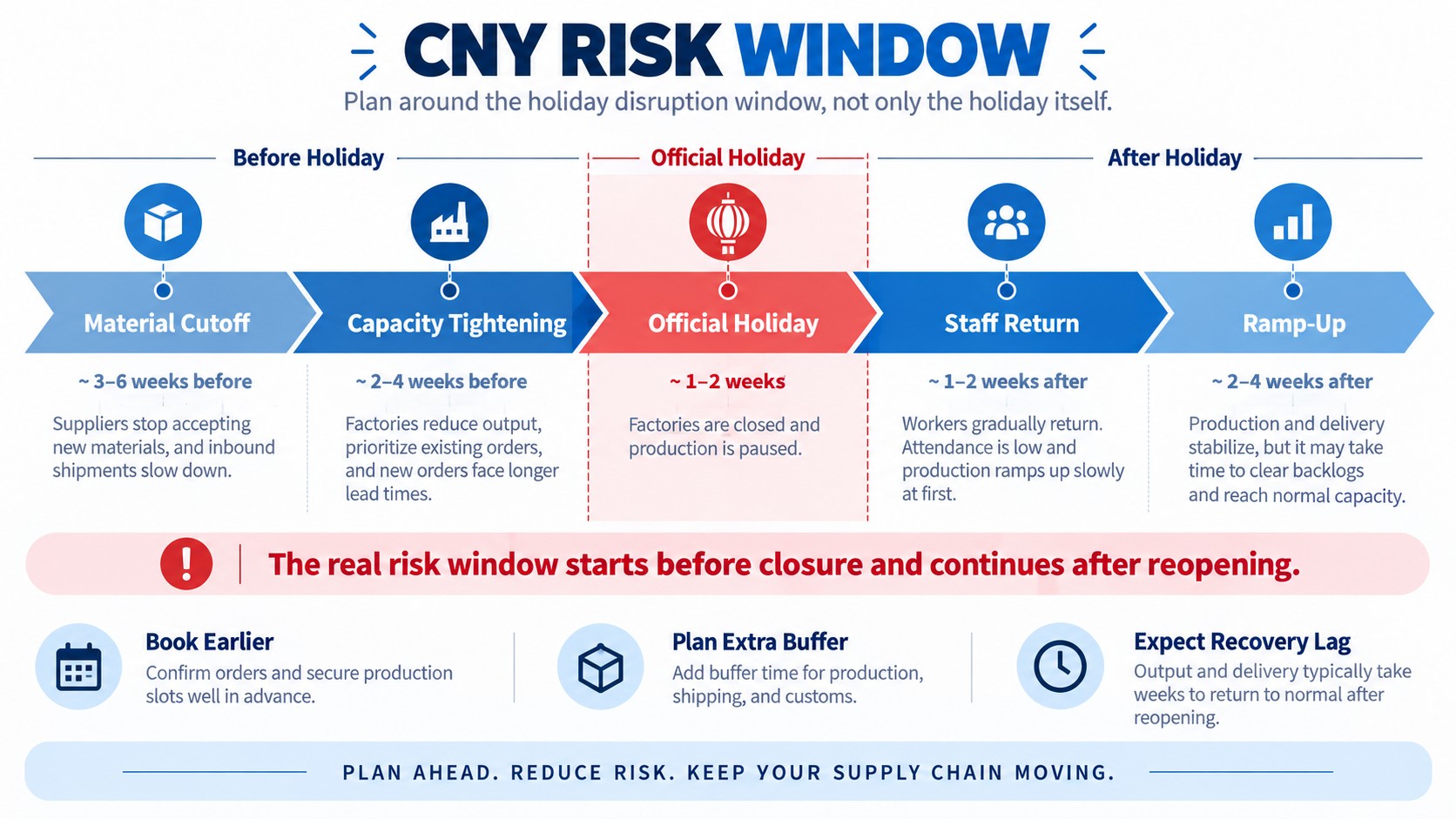

Chinese New Year Risk Starts Before the Holiday
The real CNY sourcing window begins weeks before the official holiday.
Upstream material suppliers may stop accepting rush orders. Factories prioritize confirmed production. Workers begin travel. Export bookings become more competitive.
For custom paddles, aim to close design and major material decisions well before the holiday if production must ship before CNY.
Restart Is Not Instant
A factory can reopen while the supply chain is still recovering.
Operators return at different times, subcontractors restart on different schedules, raw-material deliveries resume gradually and the first production batches may require extra quality attention.
Do not plan a major product launch on the assumption that full capacity returns the first morning after the official holiday.
National Day / Golden Week Creates a Second Planning Point
The October National Day holiday is shorter than Spring Festival but can still interrupt late-Q3 and Q4 production.
If a product needs to arrive for holiday retail, Q4 tournaments or year-end promotions, avoid leaving artwork approval, packaging printing or final production until the last days of September.
Book inspections and freight with the holiday calendar in mind.
Plan Samples, Packaging and Certification Backward
Sampling Has Its Own Calendar
A first prototype, controlled revision, production-intent sample and golden sample may each require material preparation and internal review.
If certification is required, add the official testing window after the production-intent construction is frozen.
Do not put sample development and mass production into one generic “lead time” field.
Packaging Can Become the Hidden Critical Path
Custom boxes, inserts, bags, barcode labels, manuals and shipping marks may come from separate suppliers.
Packaging approval often starts late because brands focus on paddle engineering first. That can create a finished paddle waiting for packaging.
Freeze packaging dimensions as soon as the physical product is stable enough to do so.

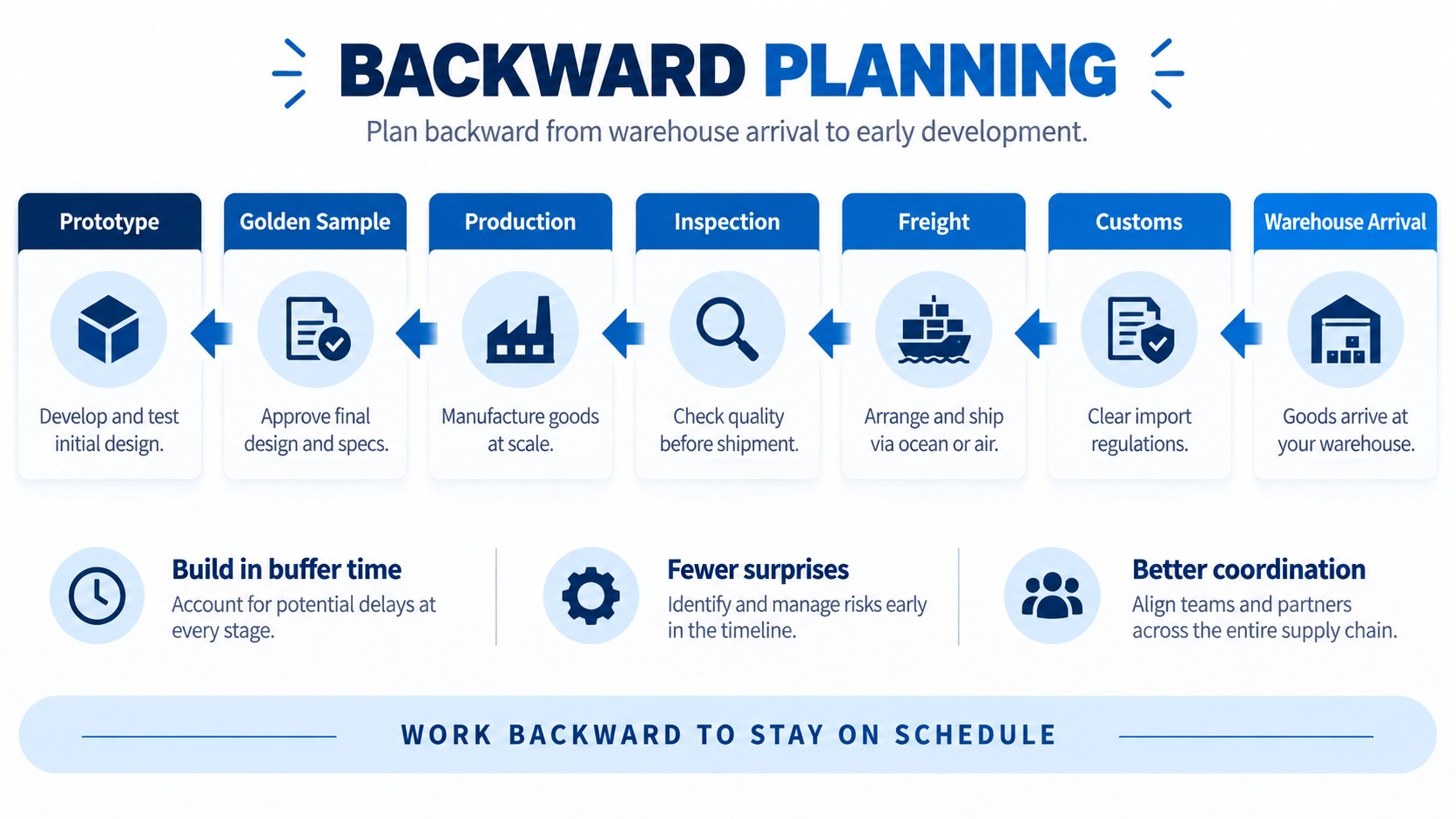

Build Backward From the Required Arrival Date
Start with the warehouse or distributor arrival date.
Subtract domestic delivery, customs clearance, international transit, export handling, inspection, production, material booking, golden-sample approval and sample development.
Then add contingency for revision and rework.
This backward calculation is more reliable than accepting one quoted “30-day lead time.”

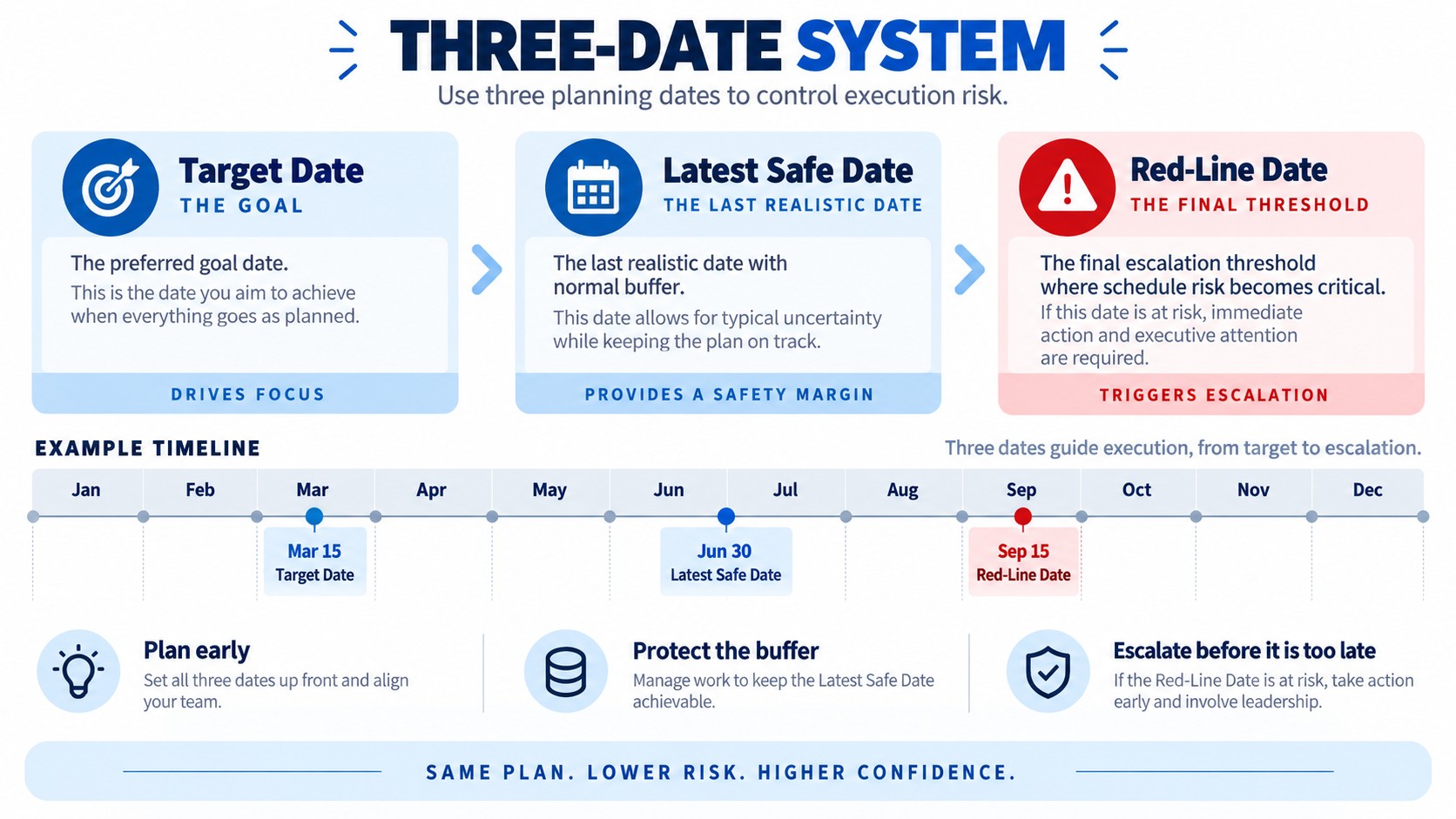

Use Three Schedule Levels
Maintain a Target Date, Latest Safe Date and Red-Line Date.
The target includes healthy buffer. The latest safe date uses most of the buffer. The red-line date means the commercial launch must change, air freight may be required, or scope must be reduced.
This gives the team a decision framework before a delay becomes a crisis.
2027 Dates: Do Not Guess the Official Shutdown
As of August 19, 2026, the official 2027 national holiday arrangement has not yet been published.
Brands can plan around the lunar calendar and expected seasonal pattern, but the exact public-holiday schedule and adjusted workdays should be updated once the State Council publishes the official notice.
A sourcing calendar should separate confirmed dates from planning assumptions.
Protect Peak-Season Production
Factory-Specific Calendar Questions
Ask each supplier when key material partners stop, when their own production stops, when staff return, when full capacity is expected and when export bookings become constrained.
Two factories in the same province can have different practical shutdown windows.
The national calendar is the starting point; the factory calendar is the operational plan.
Example: Backward Plan for an October Retail Launch
Suppose inventory must reach a U.S. warehouse by early September for an October retail campaign. Work backward from warehouse arrival through customs and domestic delivery, ocean or air transit, export handling, final inspection, mass production, packaging completion, golden-sample approval and any certification gate.
If this backward plan puts mass production in late August and packaging approval in September, the plan is already broken. The calendar exposes the conflict before the PO is released.
Repeat Orders and New Development Need Different Buffers
A repeat order using frozen materials, artwork and packaging can often be planned with a shorter engineering buffer. A new thermoformed model, new mold, new surface technology or new certification path needs much more time.
Maintain separate planning templates for repeat replenishment, cosmetic private label, construction customization and full new-product development.
Annual Page Maintenance Rule
Every November or when the State Council publishes the next year’s national holiday notice, update this page’s confirmed dates. Then ask key suppliers for their factory-specific shutdown and restart dates.
Do not simply change the year in the title. The value of the page is the combination of official dates, manufacturing reality and backward launch planning.
Build a Sourcing Calendar
Backward Sourcing Calendar
| Milestone | Work Backward From | Risk Buffer |
|---|---|---|
| Warehouse / retail date | Required commercial arrival | Domestic delivery + customs |
| International shipment | Booked departure | Export handling + inspection |
| Mass production | Production release | Material + capacity buffer |
| Golden sample | Frozen design | Revision / packaging buffer |
| Certification | Submission-ready product | Official test window + failure contingency |
Sources / Current-Update Notes
- China State Council 2026 Holiday Notice — 2026 Spring Festival: Feb 15–23; National Day: Oct 1–7. 2027 exact dates should not be invented before the official notice. Primary source
Plan Around Factory Reality, Not Only Public Holidays
Public holiday dates are only the visible part of sourcing risk. Material suppliers, printing partners, packaging factories and assembly lines may slow down before or after the official closure, and experienced workers may return at different times. A sourcing calendar should therefore include a factory-specific capacity window in addition to the official holiday schedule.
For a launch tied to retail or certification, work backward from the required warehouse date and mark the last safe dates for artwork freeze, golden sample, certification submission, packaging approval and material booking. This makes holiday planning part of product development rather than a last-minute logistics problem.
- Keep official holiday dates separate from factory-specific shutdown estimates.
- Book long-lead materials before peak-capacity periods.
- Do not publish exact 2027 holiday dates until the State Council issues them.
Frequently Asked Questions
When should I place orders before Chinese New Year?
Work backward from the required shipment date and confirm material booking and factory shutdown windows. Custom projects should be frozen substantially earlier than simple repeat orders.
What were the official 2026 Spring Festival dates?
February 15–23, 2026, according to the State Council holiday arrangement.
What are the 2026 National Day dates?
October 1–7, 2026, under the official 2026 arrangement.
Are 2027 holiday dates confirmed?
Not yet as of August 19, 2026. Update the page when the State Council publishes the official schedule.
Should I use factory quoted lead time only?
No. Include material, samples, certification, packaging, inspection, freight and restart buffers.
Building a 2026 sourcing calendar?
Mayvoci can help translate your launch date into sample, material, production, inspection and shipment milestones.
The End about Mayvoci
1)Design:Over 100 paddle designs and photography service to assist start-up.
2)Professional:Focus on various of paddles manufacturing for 6 years
3)Quality:Strict quality management system to provide safety and satisfaction for customers
4)Amazon:Flexible comprehensive solution to make sure each Amazon seller is well cared.
5)Excellent Team:Experienced paddle experts & dynamic sales team give you 5-star service
